COMPLETED PROJECT
Kolandoto Hospital in Tanzania
The project is part of our long-term initiative Healthy Hospitals Tanzania.
TIME FRAME
Active phase: 2015-2017
PROJECT OBJECTIVES
Primary: Reduce morbidity and mortality in the Shinyanga region.
Secondary: Learning outcomes for involved organisations and individuals.
PARTNERS
Kolandoto Hospital, Involvaid, Engineers Without Borders Sweden, Architects Without Borders Sweden
IMPLEMENTATION
All implementations were chosen by the hospital management team to reduce morbidity and mortality. Key activities included:
8 master theses by 14 Chalmers University of Technology students, each spending two months at Kolandoto Hospital.
Professional visits by nurses, architects, civil engineers, and electrical engineers.
Creation of a hospital master plan with a Swedish architect.
Major implementations: increased water availability and quality, stabilized and solar-assisted electricity supply, construction of an emergency department, and creation of a mass casualty plan.
STATUS
Completed
VALUE
Infrastructure improvements worth 963,000 SEK (90,161 USD)
CONTINUATION
Kolandoto Hospital's sister hospital, Mkula Hospital, faces similar challenges. A survey in 2017 laid the foundation for a new project in 2018-2019.
BACKGROUND
Access to health care is a human right and a humanitarian issue. The Kolandoto Hospital has a history of successful, sustained projects, showing the competence of its management team. The project, initiated in 2014, was a collaboration between Kolandoto Hospital, Involvaid, Engineers Without Borders, and Architects Without Borders. These NGOs rely on volunteers and small donor support.
Motivation and Principles
Healthcare is a humanitarian issue with a direct impact on lives.
Long-term foreign aid projects offer valuable learning experiences.
Decisions on investments were made by the hospital management team.
Ensuring ownership through decision-making and co-financing by Kolandoto Hospital.
Supporting local procurement to ensure ease of maintenance and upgrades.
Long-term presence to develop cultural understanding and good relations.
Project Phases & Timeline
Designs and Implementations
Phase I - 2015
Masterplan design
Water pump installation
Maternity theatre design and construction
Eye clinic design
Phase II - 2016
Dosatron installation
Waste zone construction
X-ray entrance construction
Emergency department design
Phase III - 2017
Emergency department construction and training
Private and maternity ward design
2015
Phase I: Masterplan design
Decades of aid dependent growth has led to inefficient logistical flows of patients, staff, material and air throughout the hospital site which create risks of medical errors, harmful service delays and cause infections.
A masterplan was developed based on numerous design iterations with hospital management and staff to guide the development of the built environment. The masterplan supports the access to appropriate healthcare in a healing environment free from factors causing illness or injuries. It defines the next 10 larger building projects and the sites for them. It also clarifies good medical zoning and flows to make the hospital site safer and easier to navigate.
The masterplan was created to give the hospital management team increased possibilities to control the development of the hospital. The first two identified building projects were completed during phase III and are in use. One more building project has been designed but not built.
Phase I: Water pump installation

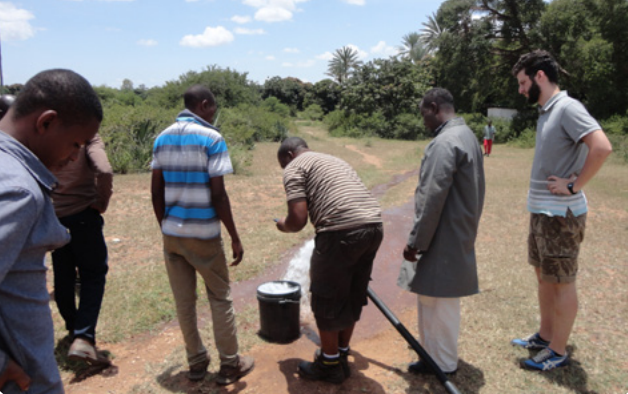

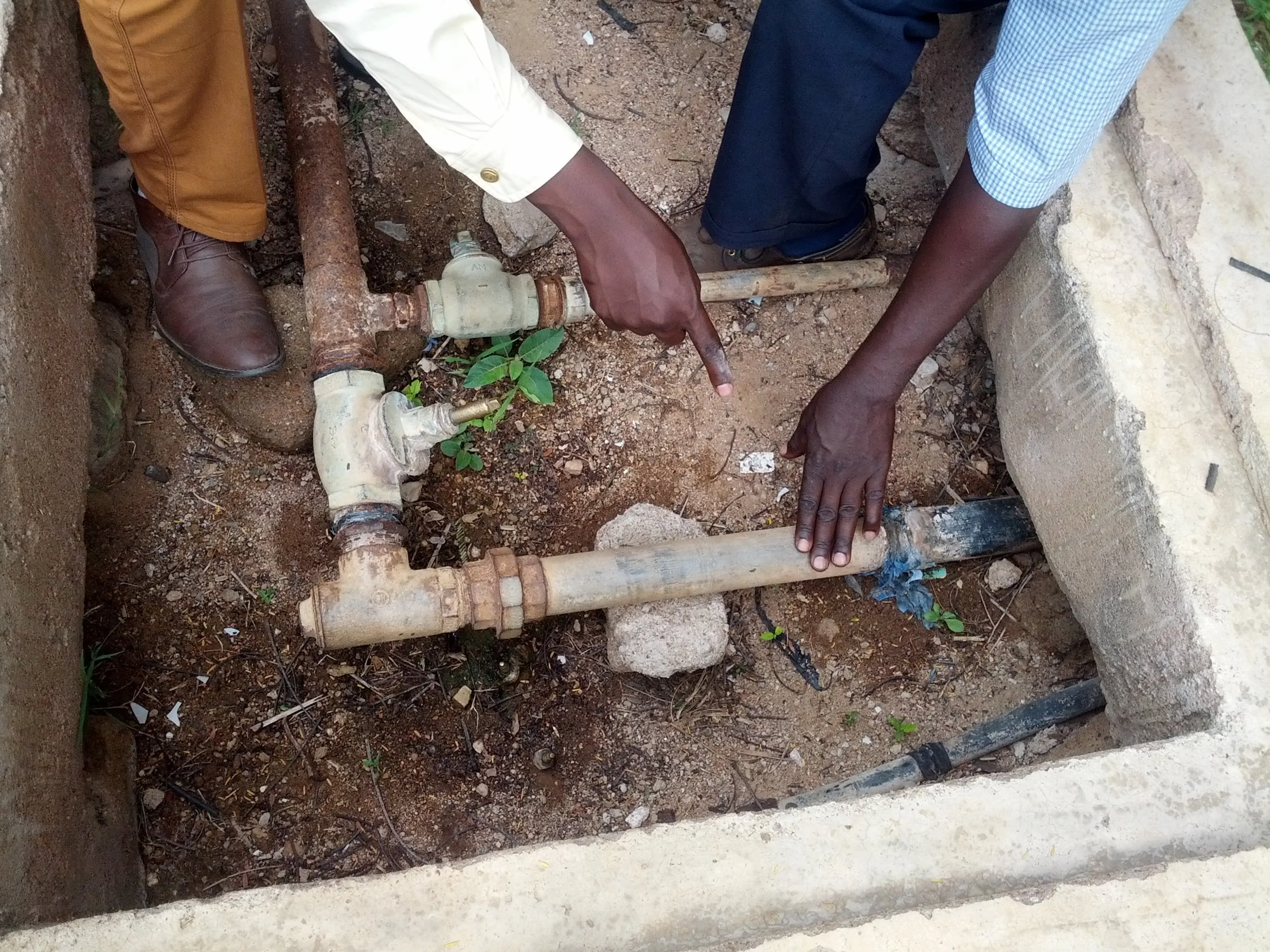

One of the main problems that the hospital management brought up in the beginning of the project was a shortage of water. There was one existing borehole with an old pump with poor capacity that provided water to the whole hospital, the nearby nursing college, and the Kolandoto village. The pump broke down often which resulted in times when there was even less available water for the hospital. The shortage of water made it difficult for the hospital to uphold appropriate and safe hygiene standards. It also resulted in shortage of quality drinking water for the inhabitants of Kolandoto as a whole, posing a considerable health risk.
After the pump testing and mapping of the current water system a submersible water pump was bought and installed in the existing borehole. The process was undertaken in close collaboration with the water team of Kolandoto and the hospital management team. A local engineering company was hired to install the pump. The new water pump has doubled the availability of water and reduced the health risks due to shortages of safe drinking water.
Phase I: Maternity theatre design and construction

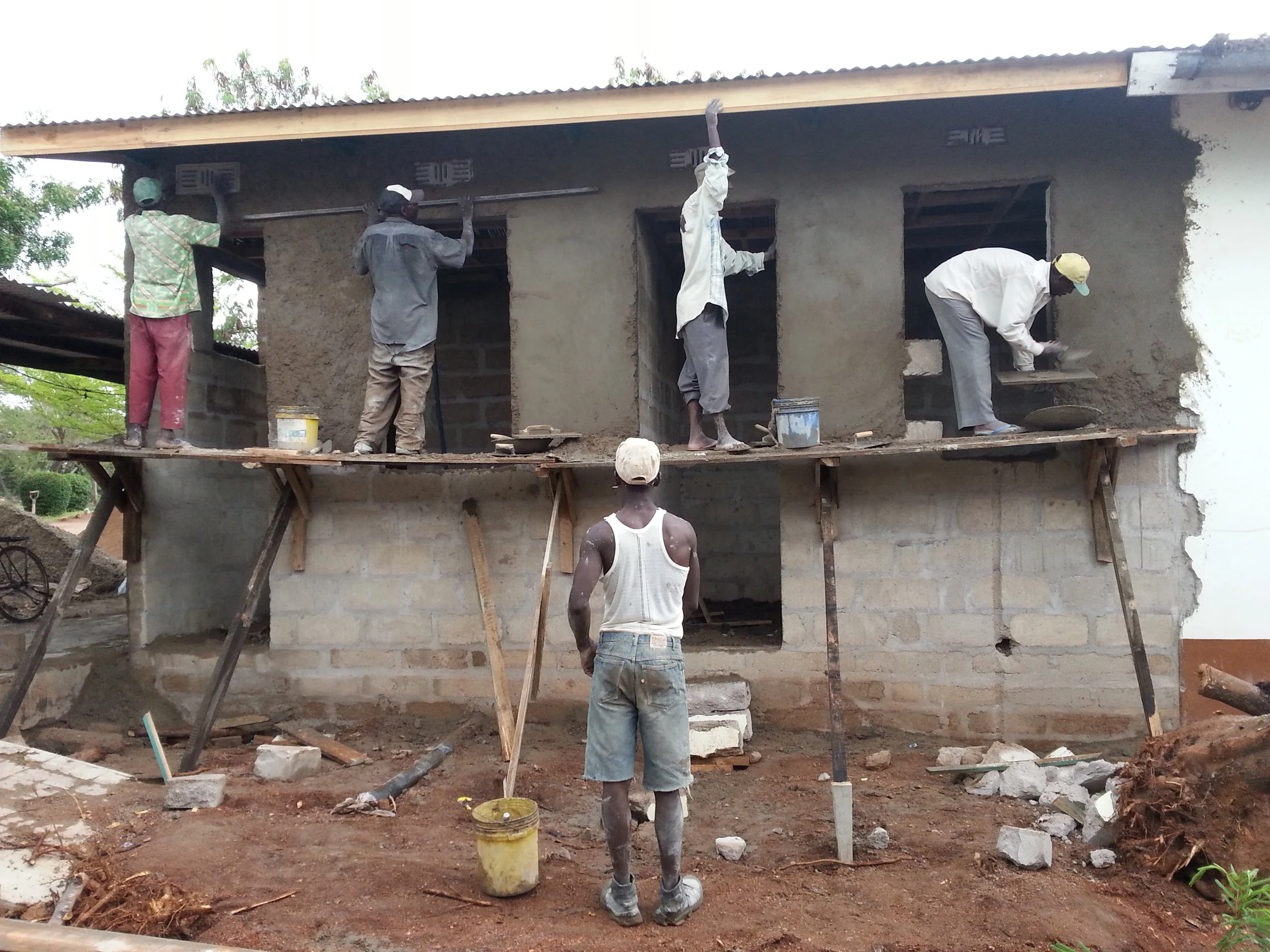

The existing operating theatre for c-sections at the maternity department was not in use in 2015 due to that the hospital could not guarantee the needed hygienic conditions for performing safe c-sections. The building lacked a place for changing clothes, scrubbing before surgery, and cleaning of used equipment and linen. Instead, pregnant mothers who were in need of emergency c-sections had to be transported out of the maternity building, along an outdoor path to go into the general operating theatre, and wait if another surgery was on-going.

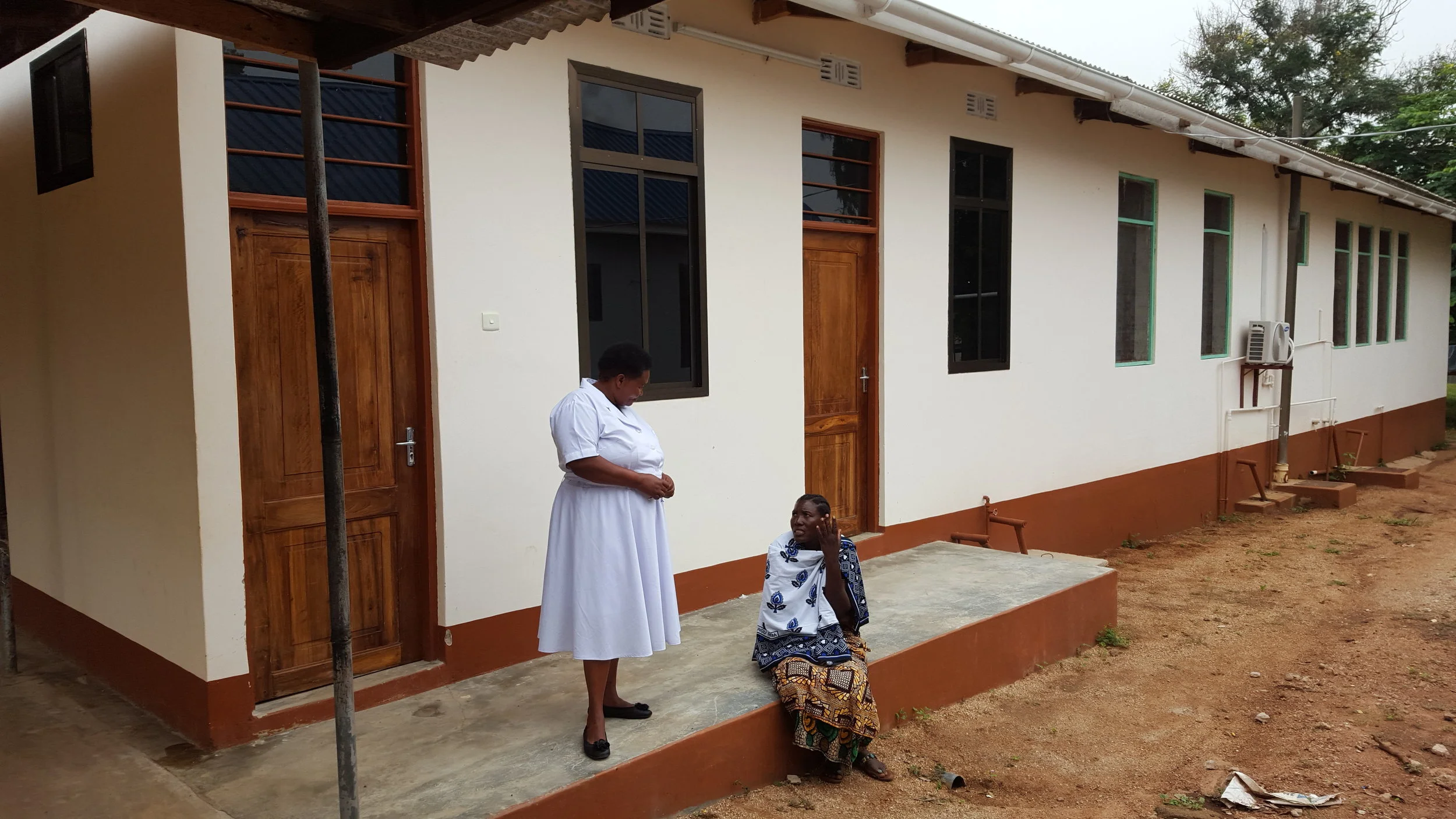

A maternity building extension to counteract these problems was designed and constructed by a Swedish project team member together with hospital staff and local craftsmen. Since completion the extension has been in use on and off. For example, during the beginning of 2016 the maternity theatre was not in use due to missing spare parts for previously donated Swedish medical equipment.
Phase I: Eye clinic design
The eye department used to consist of two buildings – the operating theatre building and one building for both the ward for inpatients and the clinic for outpatients. The outpatient clinic was small and crowded which resulted in poor patient privacy as well as a risk of transmission of infections. Kolandoto Hospital had at the time already in mind to construct a new building for the eye clinic. A design proposal from a local firm had been made, but the design was too large for the available sites.
Assistance was provided in both writing a funding application to send to a German NGO, and with making a new design proposal adapted to the site and spatial needs expressed by staff. The proposal was a clear, calm and comfortable building design based on building techniques adapted to the local climate.
Two years later, in 2017, the Kolandoto Hospital received funding for the building and hired a local contractor to build it.
2016

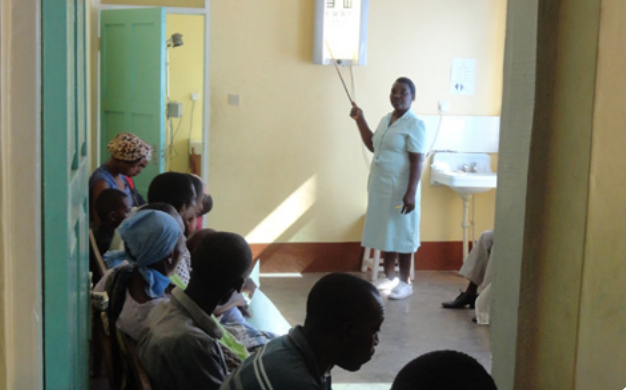

Phase II: Solar cells and UPS installation
One larger problem at Kolandoto Hospital were the frequent power cuts which led to medical hazards at the three operating theatres. Installing an UPS-system (Uninterruptible Power Supply) would prevent power cuts mid-surgery; an UPS is working as an instant back-up system for electricity.
Three separate UPS-systems with feeding solar cells were installed in the eye theatre, general theatre and in the maternity theatre. The solar power does not only work as a power bank for the UPS but also as an asset for lowering the cost of electricity. Each individual UPS was therefore also dimensioned for future expansion.
Power cuts during surgery dropped from approximately two to zero times per week. Furthermore, the hospital electricity bill also reduced by approximately 50%. This cost reduction was well received by the Kolandoto Hospital since the hospital economically operate at the margin, and even have challenges in paying staff salaries. In 2018 the Kolandoto management team specifically asked if it was possible to further increase the solar electricity capacity.
Phase II: Dosatron installation
When the water pump was installed during phase I, a water quality test was conducted. The test showed the presence of e. coli in the water. E. coli is an indicator of faecal contamination which can cause water related disease outbreaks and health hazards for the weaker individuals who are staying at the Kolandoto Hospital and in the Kolandoto Village.
A dosatron which adds an adjustable dosage of chlorine was installed to disinfect the water. Trainings were provided for the Kolandoto technical team to operate and run the dosatron. The same company that installed the water pump and the UPS and solar electricity system was hired for the installation to ensure that the hospital easily could receive technical support if needed.
Phase II: Waste zone construction

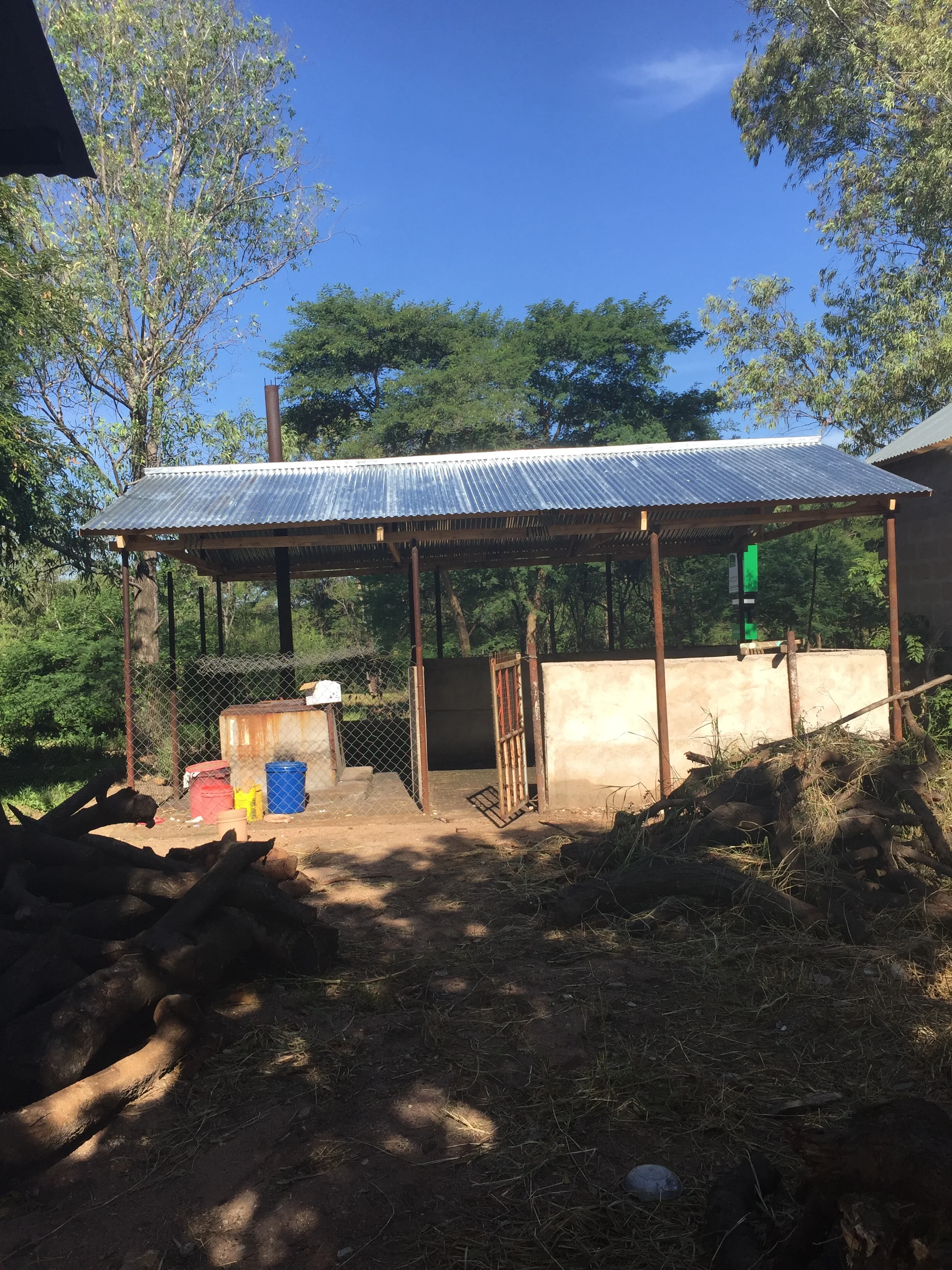

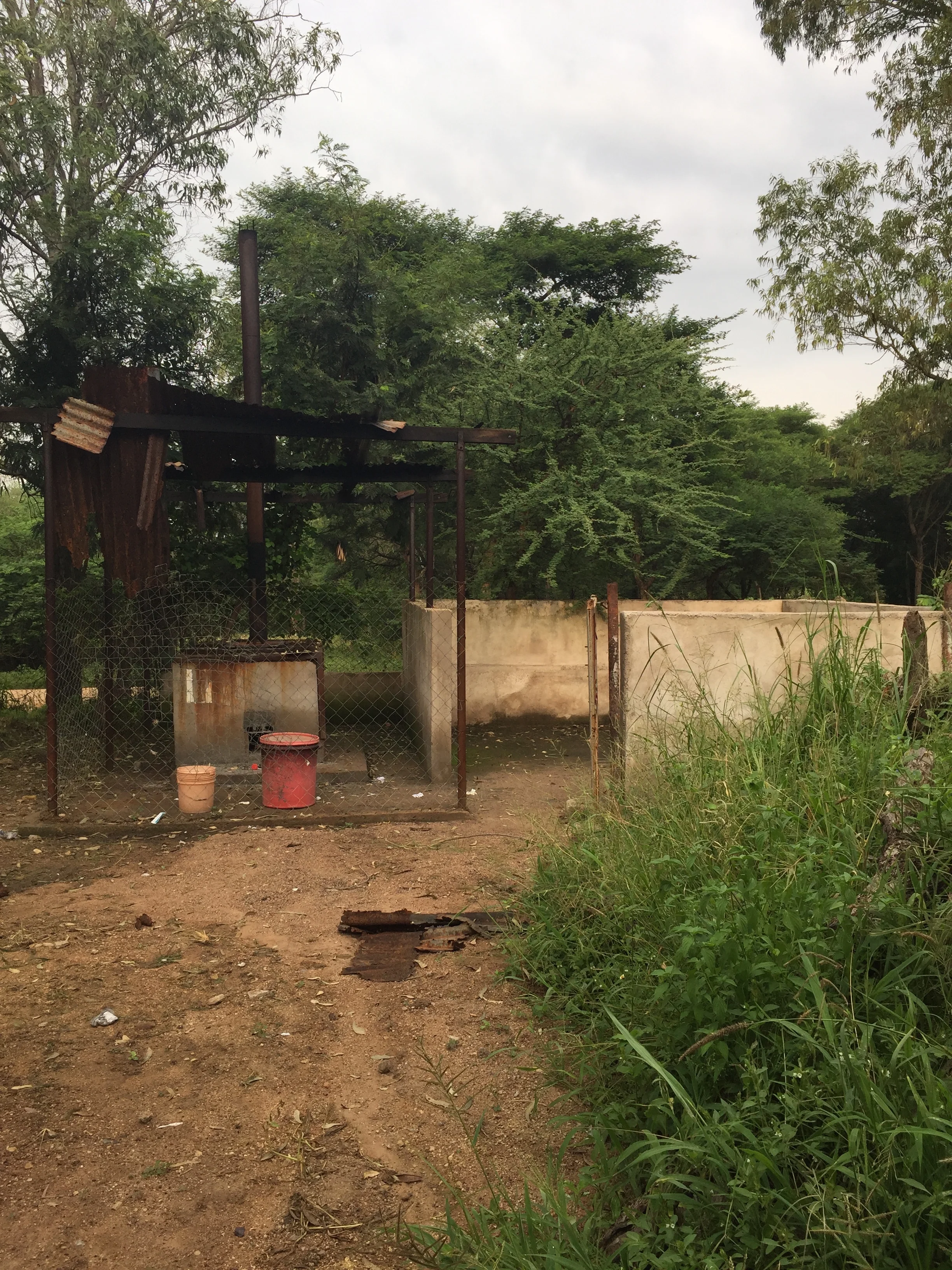

The waste zone had deteriorated because of a lack of funding and the need to prioritize more central hospital functions. While the waste zone itself is not an immediate health risk for the patients, a functioning waste system is. It is much easier to implement proper infection control if the hospital waste zone is working well. In addition, the staff concerned with handling waste are exposed to health risks if the waste zone is not safe to operate.

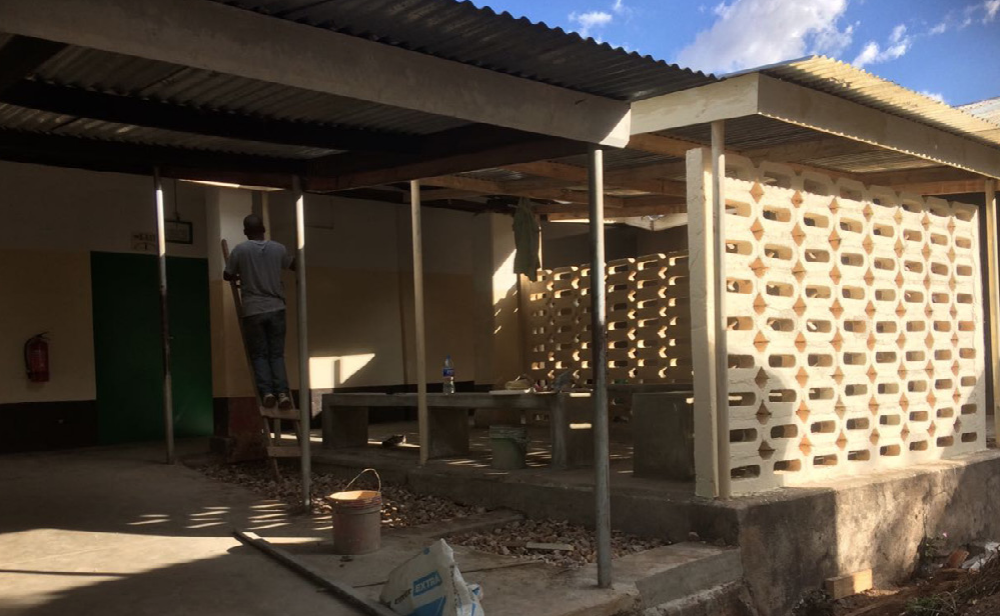

As a minor project implementation, the waste zone was given a new roof and new tools were purchased for safe separation and management of waste fractions.
Phase II: X-ray entrance construction
The masterplan identified the emergency department as the second larger building project to be made. To provide proper emergency department services a functioning x-ray and imaging department is key. The masterplan identified that the flows in between the site for the emergency department and x-ray department had to be simplified to not cause dangerous delays in the care. In addition, the door to the x-ray department was too small for stretchers to come through, which resulted in patients being dangerously carried on mattresses instead.
A reorganization and primarily a new entrance situation to the x-ray department was designed together with staff. A new waiting area, a new wide entrance door, and a new reception window was constructed and installed. The entrance to the x-ray department is now located in close connection to the emergency department and the general operating theatre which makes it easily accessible. The waiting area is outside with solar shading to make it comfortable. The door to the room with the x-ray machine is wide enough for injured patients to be safely transported on a stretcher.
PHASE II: Emergency department design
Kolandoto Hospital did previously not officially provide emergency health care, although there was a need for it and patients did arrive at the hospital in a state of emergency. The emergency flow of patients was undefined, inefficient, and caused dangerous delays in providing critically ill patients with care. To build an emergency department was the second large building project in the masterplan. In addition, having an emergency department is one criteria of fully becoming a ‘Council Designated Hospital’, which is an official type of hospital receiving certain government funds.
A design proposal for a new emergency department building was developed through a design process that focused on participative methods to generate the best ideas adapted to local health care requirements and the local culture.
Since the design proposal was made as part of an architectural master thesis it became a bit too large and difficult to construct. After the thesis was finished the building design was simplified and made smaller and more economically realistic.
2017

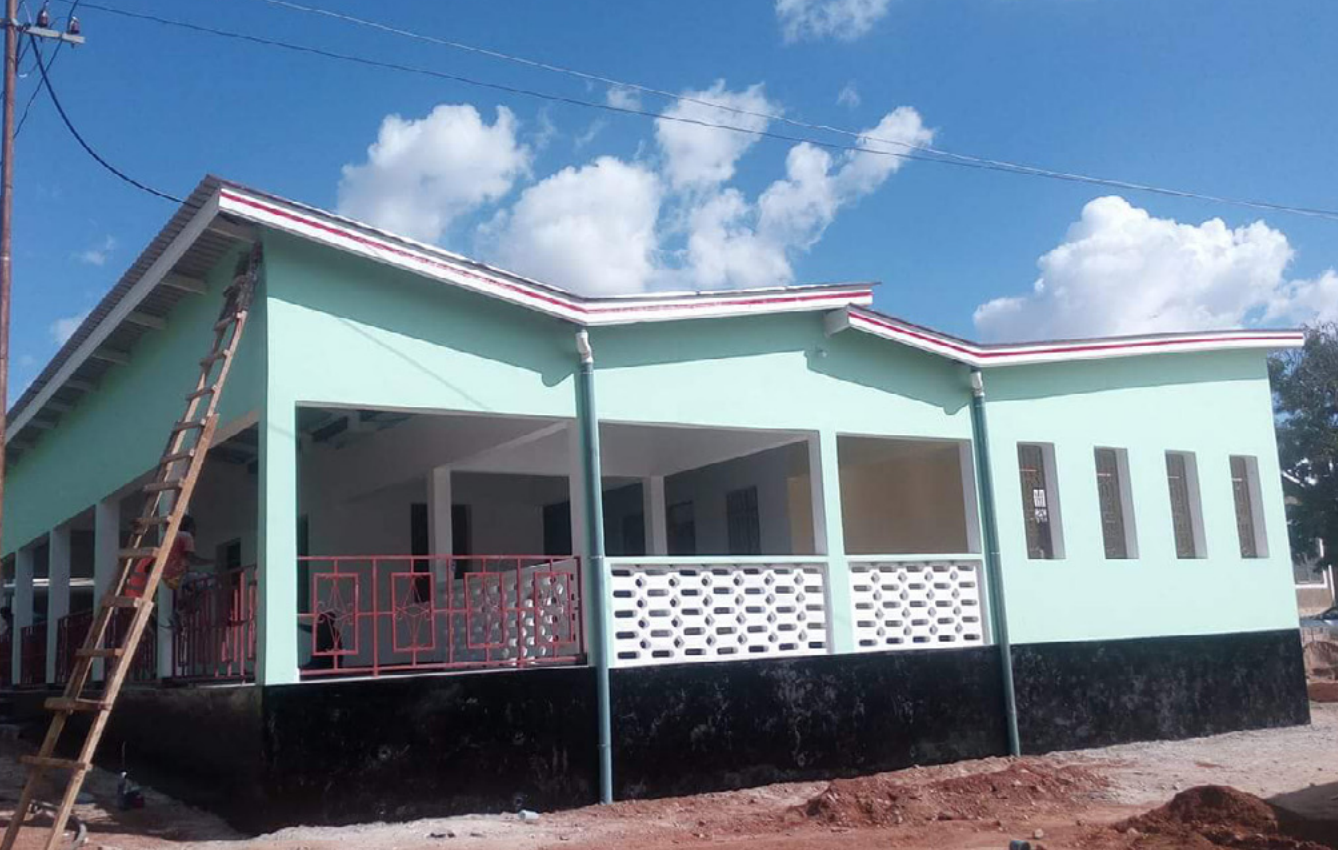

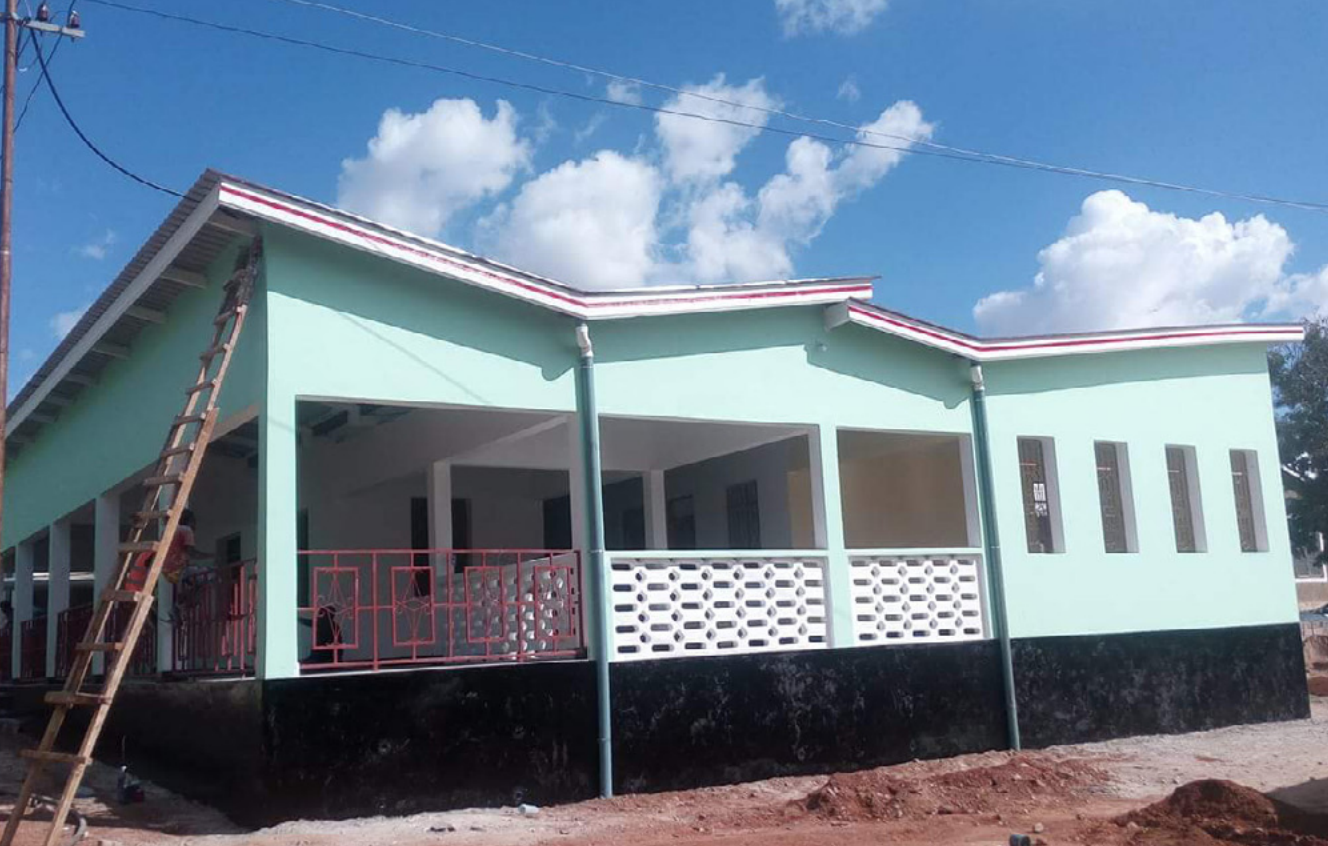

PHASE III: Emergency department construction and training
In addition to the spatial and physical needs to provide emergency care, the hospital staff was not trained in emergency care and there was no mass casualty plan in place.
A procurement process was carried out by the hospital management assisted by the Swedish engineering students, to find a suitable local contractor to construct the building. A contractor was selected, who then constructed the building in six months. In addition to the construction of the emergency department, simple Swedish medical equipment, such as stretchers and trolleys, were sent to equip the emergency department. To provide capacity building for the staff a series of meetings, workshops and mass casualty trainings was conducted.
Kolandoto Hospital emergency department is the first in the region. Two years prior to the construction, meetings were held with regional medical officers to anchor the plan of building an emergency department at Kolandoto with mass casualty capacity. A learning outcome was that construction errors can be avoided by having a physical 3D model available for the contractors and workers at the construction site.
PHASE III: Private and maternity ward design
The third large building project identified in the masterplan was the private ward and maternity ward. The current maternity ward does not have enough capacity as it shares the building with the private ward. The congestion of inpatients poses a risk of transmission of diseases and infections. With an increasing number of patients coming to give birth at the hospital for free, it is even more needed to expand the facilities. At the same time there is a growing demand for private care. Constructing a new private ward with higher standards in terms of sanitary facilities and single/double patient rooms is therefore an income opportunity for the hospital since patients seeking private care pay more.
Design proposals for a new private ward and maternity ward was made in close collaboration with both staff and patients. The private ward is designed to resemble a village with smaller houses. In the proposal the maternity ward is extended to occupy the whole existing building. A new extension is included to accommodate mostly single/double patient rooms. The outdoor spaces are designed to provide social and healing spaces.
